Landmark Middle School Modernization for Moreno Valley Unified School District

The first campus wide modernization for this nearly 35 year old campus was most overdue. A chance to transform dull finishes and dimly lit classrooms to bright inspiring spaces. We were grateful for the opportunity to make a generational impact to our future students.

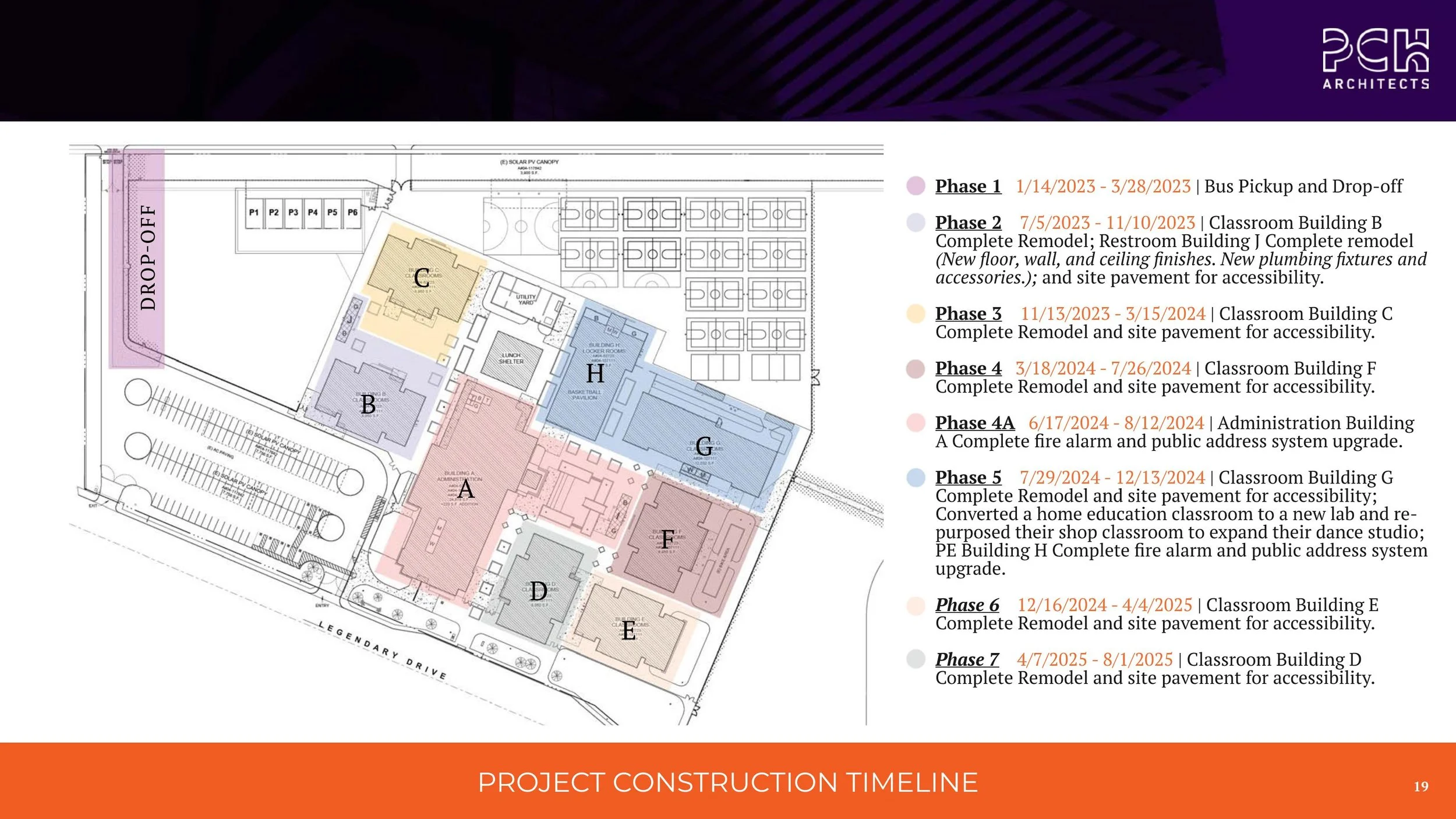

Phase 1    Site Work:  Remove and replace portion of existing fencing and turf to allow for new walkway for bus pickup and drop-off.

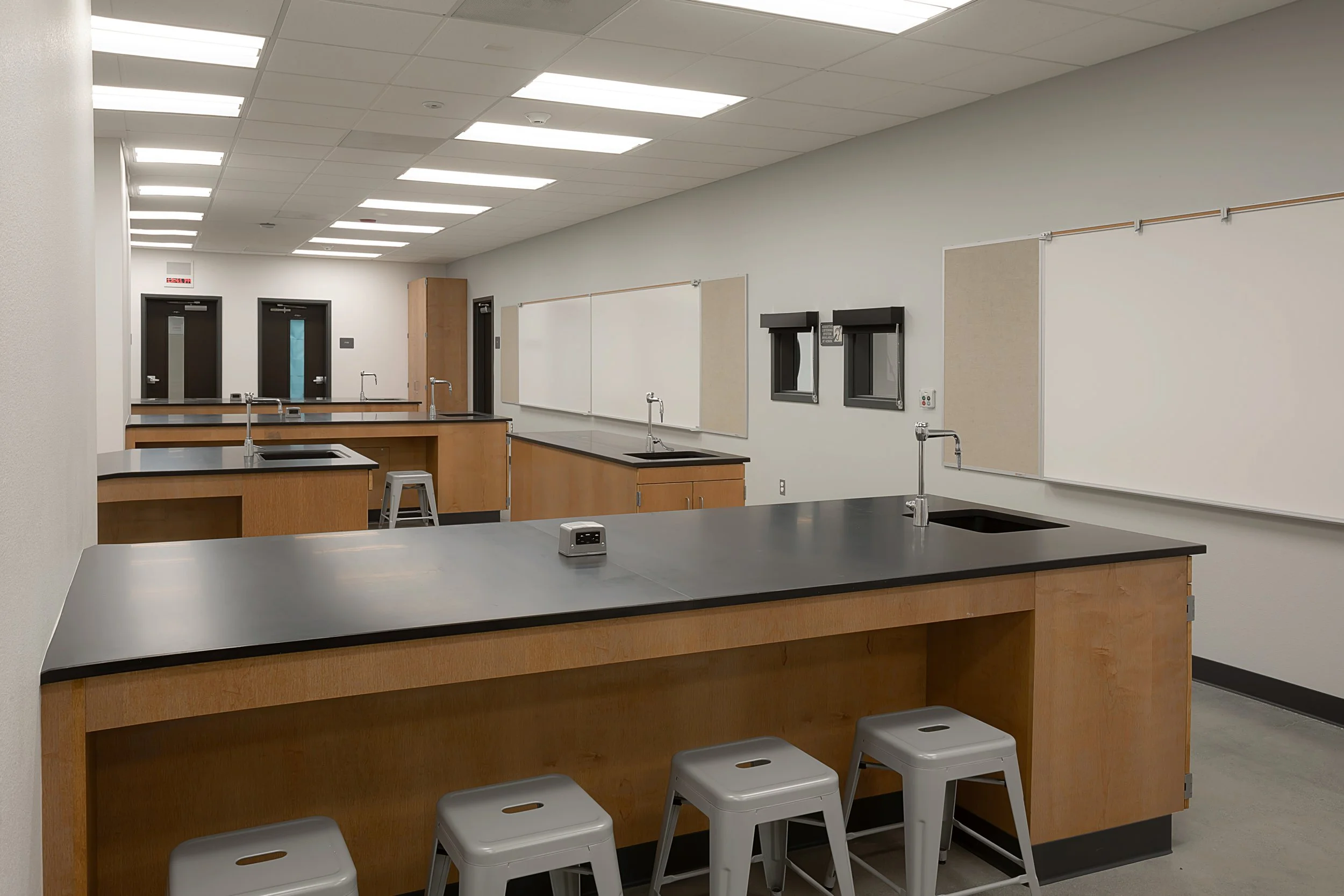

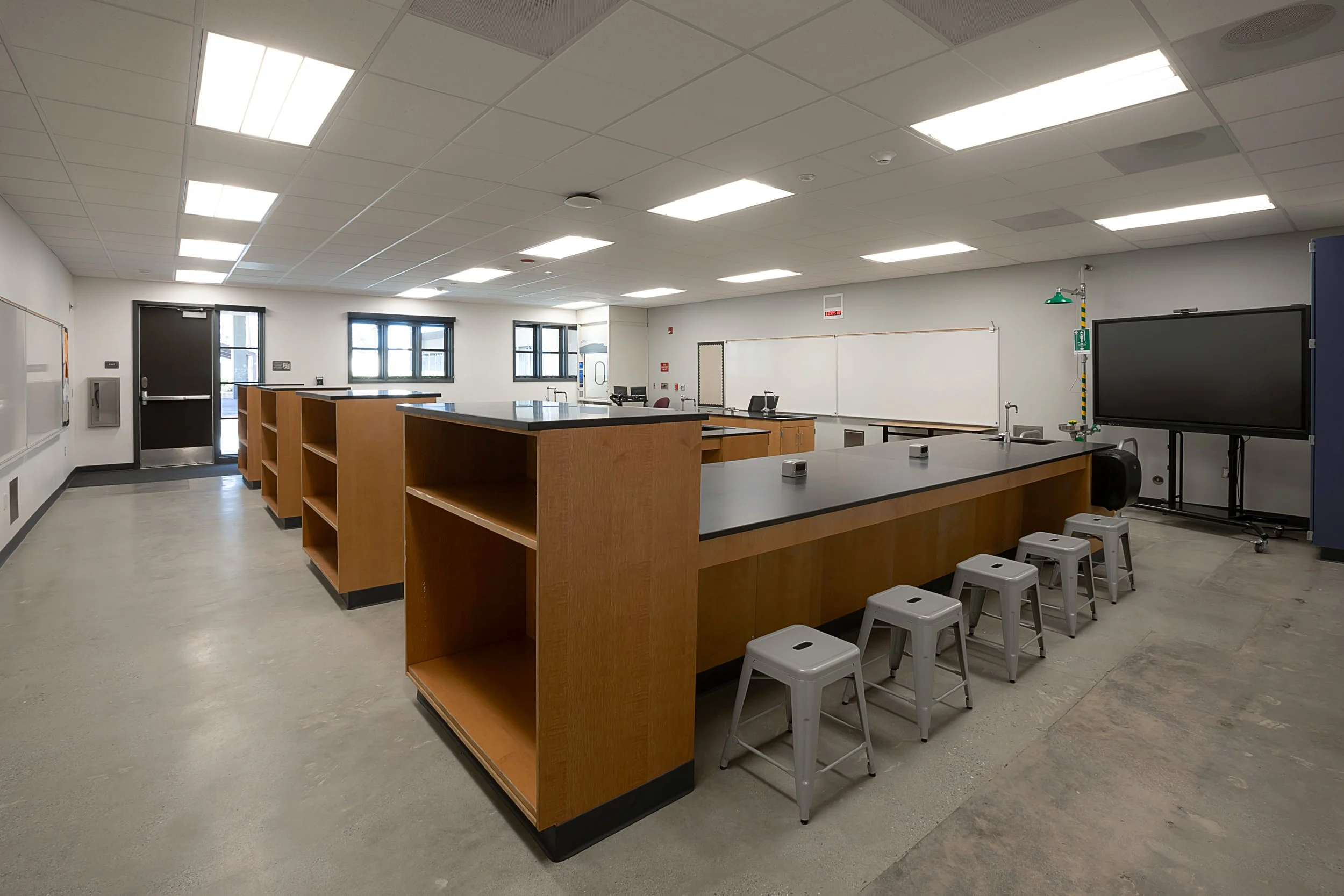

Phase 2    Site Work:  Remove and replace portions of adjacent site pavement for accessibility;  Classroom Building B:  Complete remodel. Replaced all floor, wall, and ceiling fi nishes with new. New casework, marker boards, lighting, door hardware, public address system, fire alarm, electrical, data, insulation, and HVAC;  Restroom Building J:  Complete remodel. Replaced all floor, wall, and ceiling fi nishes with new. New plumbing fi xtures and accessories.

Phase 3   Site Work:  Same is in Phase-2;  Classroom Building C:  Same as in Phase-2.

Phase 4 & 4A    Site Work:  Same is in Phase-2;  Classroom Building F:  Same as in Phase-2. In addition to converted central workroom into a shared lab classroom;  Administration Building A:  Complete fi re alarm and public address system upgrade.

Phase 5    Site Work:  Same is in Phase-2;  Classroom Building G:  Same as in Phase-2. In addition to converting a home education classroom to a new lab and re-purposing their shop classroom to expand their dance studio;  PE Building H:  Complete fi re alarm and public address system upgrade.

Phase 6    Site Work:  Same is in Phase-2;  Classroom Building E:  Same is in Phase-2.

Phase 7    Site Work:  Same is in Phase-2;  Classroom Building D:  Same is in Phase-2.
